Cleaning & Corrosionprotection for glycol systems

Published on

04 August 2026

Share

Technical Insight – Glycol Systems Under Pressure

Closed-loop glycol systems, commonly used for HVAC and industrial cooling, face two critical challenges: fouling and corrosion. Over time, glycol degrades into organic acids, lowering pH and accelerating metal attack. Simultaneously, biofilm and particulate accumulation impair heat transfer, leading to performance drift and energy inefficiency. Without proactive chemical cleaning and corrosion protection, these systems become costly liabilities—both in terms of maintenance and asset longevity.

As water treatment professionals, it is our responsibility to ensure long-term system integrity through rigorous monitoring, targeted cleaning procedures, and tailored corrosion inhibitor programs.

Client Case – Major North American Wastewater Facility

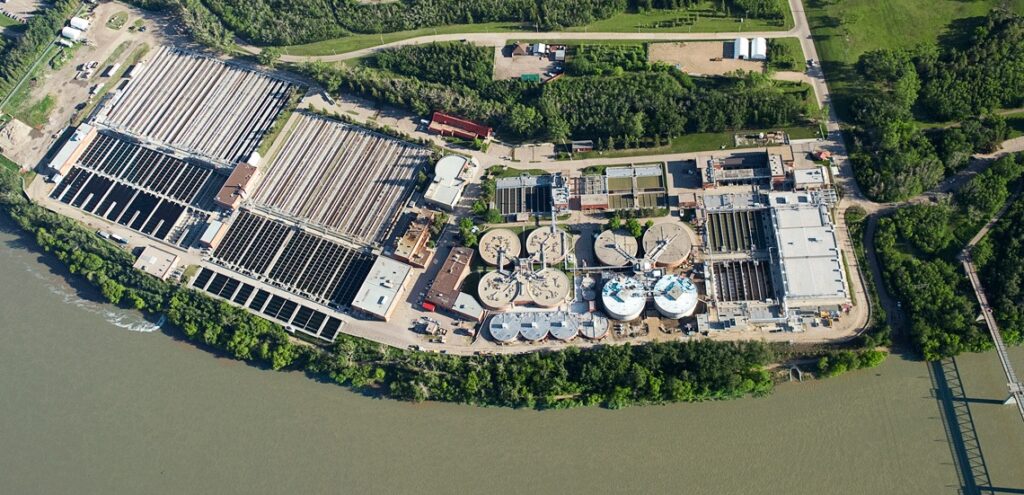

A major wastewater treatment plant, one of the largest in North America, operates multiple glycol heating loops integrated across both facility buildings and critical process zones.

Nouvelle note ODYSSEE Environnement
Nouvelle note ODYSSEE Environnement

System

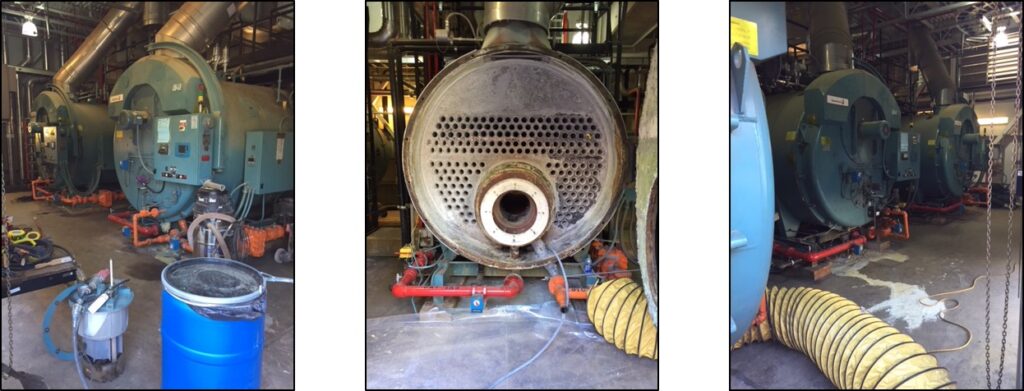

BOILER HOUSE : 5 boilers, one of which is always down for maintenance.

Nouvelle note 1 ODYSSEE Environnement
Nouvelle note 1 ODYSSEE Environnement

Solution

Treatment Strategy:
The corrosion control program implemented relied on a formulation fully compatible with glycols. The dual-action mechanism includes:

This approach rapidly became a standard treatment model for glycol-based systems in North-America.

Implementation Notes:

Technical Outcome:
The strategy enabled both system cleaning and long-term corrosion protection without shutdown, while maintaining stable pH and minimal turbidity—a robust operational benchmark for similar facilities.

Nouvelle note 2 ODYSSEE Environnement
Nouvelle note 2 ODYSSEE Environnement

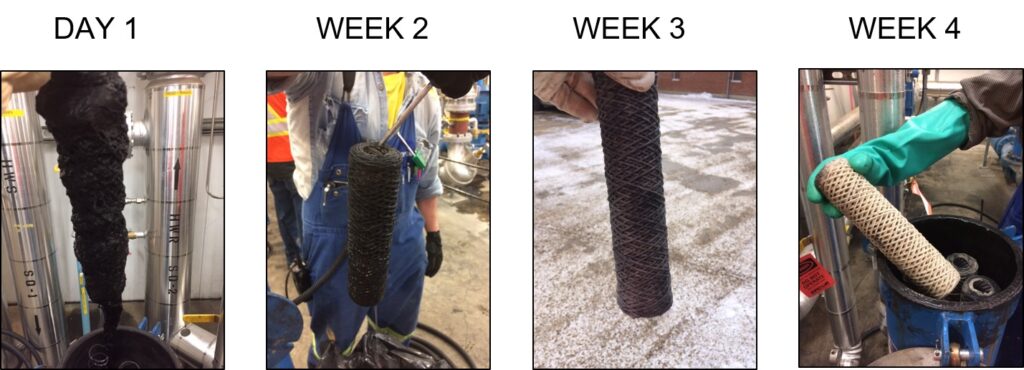

After 4 weeks of treatment, the filters showed no visible fouling—indicating successful deposit removal and stabilization of the system. Dissolved iron levels were consistently under control, confirming the effectiveness of the corrosion inhibition and cleaning program.

At this stage, Boiler #3—which had remained offline—was brought back into operation. This reactivation triggered a new cleaning phase lasting several weeks, during which similar monitoring protocols (filter changes, iron tracking) were maintained to ensure uniform protection and system-wide cleanliness

Nouvelle note 3 ODYSSEE Environnement
Nouvelle note 3 ODYSSEE Environnement

Visual Confirmation of System Cleaning

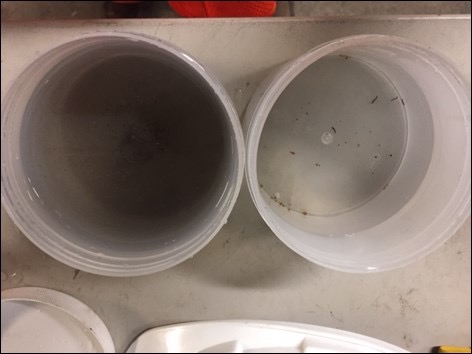

The cleaning process significantly improved water clarity.
The image below illustrates the impact of the treatment: on the left, the initial water appearance at the start of the film-forming amine (FFA) injection; on the right, the clear water condition observed at the end of the cleaning phase.

This visual transition confirms both the efficacy of deposit dispersion and the restoration of hydraulic cleanliness within the glycol loop.

Nouvelle note 4 ODYSSEE Environnement
Nouvelle note 4 ODYSSEE Environnement
